US AI data center map
Where the US AI buildout is going, state by state: planned data center capacity from reviewed project evidence, with site counts, named owners, and the industrial power price behind each siting decision. Select a state for its full evidence record.
Texas leads announced capacity at 6.8 GW across 8 planned sites. Wisconsin follows at 4.0 GW. 16 states carry 30.1 GW of reviewed planned capacity between them.
Planned AI data center capacity choropleth
- 4 GW +
- 2–4 GW
- 1–2 GW
- 500 MW – 1 GW
- Under 500 MW
- No published planned capacity
Planned capacity, ranked
| # | State | Planned capacity | Sites | Named owners | 2025 capex estimate | Industrial power |
|---|---|---|---|---|---|---|
| 1 | Texas | 6.8 GW | 8 | CoreWeave, Google, Meta, Microsoft, Oracle | $186B | 6.33¢ / kWh |
| 2 | Wisconsin | 4.0 GW | 2 | Microsoft, Oracle | $119.9B | 9.00¢ / kWh |
| 3 | Indiana | 3.3 GW | 2 | Amazon, Google | $105.6B | 9.08¢ / kWh |
| 4 | Louisiana | 2.3 GW | 1 | Meta | $63.5B | 6.88¢ / kWh |
| 5 | New Mexico | 2.2 GW | 1 | Oracle | $59.8B | 4.45¢ / kWh |
| 6 | Ohio | 2.1 GW | 3 | Google, Meta | $64.1B | 9.87¢ / kWh |
| 7 | Iowa | 1.9 GW | 2 | $52.8B | 6.62¢ / kWh | |
| 8 | Mississippi | 1.8 GW | 2 | Amazon | $57.7B | 7.50¢ / kWh |
| 9 | Michigan | 1.4 GW | 1 | Oracle | $37.4B | 9.43¢ / kWh |
| 10 | Virginia | 1.0 GW | 3 | CoreWeave | $26.6B | 10.53¢ / kWh |
| 11 | Nebraska | 918 MW | 3 | Google, Meta | $28.7B | 9.25¢ / kWh |
| 12 | Oklahoma | 623 MW | 2 | CoreWeave, Google | $19.7B | 6.17¢ / kWh |
| 13 | North Dakota | 520 MW | 1 | CoreWeave | $15.2B | 8.27¢ / kWh |
| 14 | New York | 509 MW | 1 | Fluidstack | $16.5B | 9.55¢ / kWh |
| 15 | Alabama | 465 MW | 1 | Meta | $13.6B | 7.89¢ / kWh |
| 16 | Wyoming | 264 MW | 1 | Meta | $8.3B | 9.12¢ / kWh |

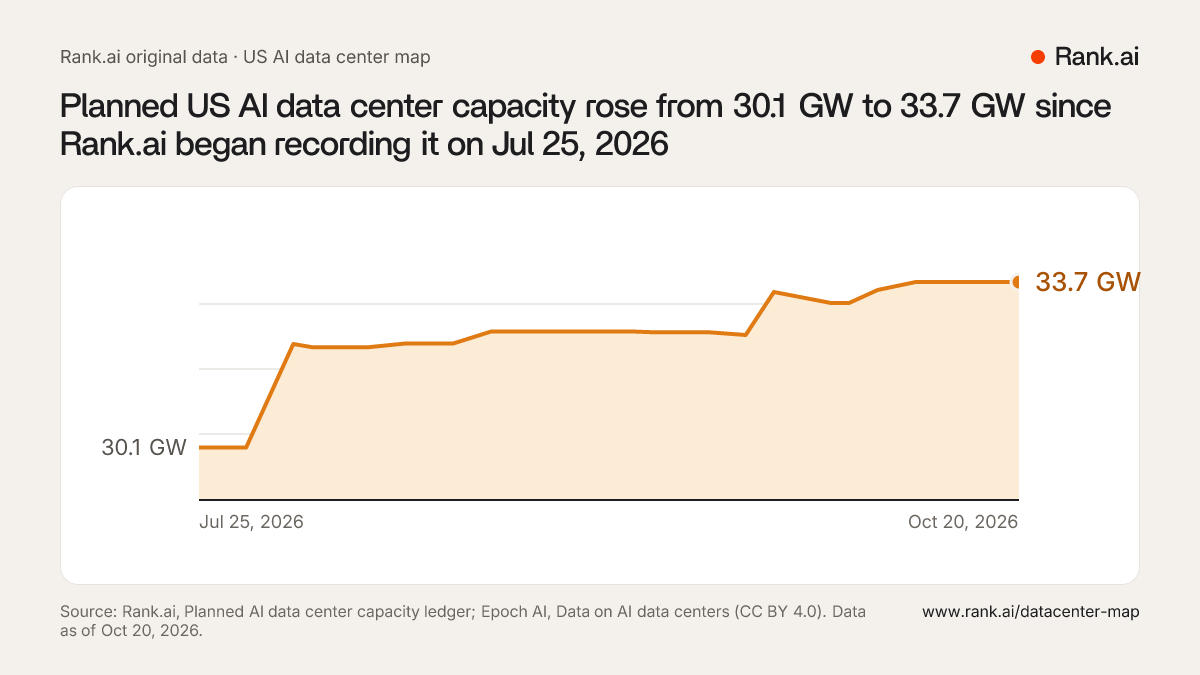

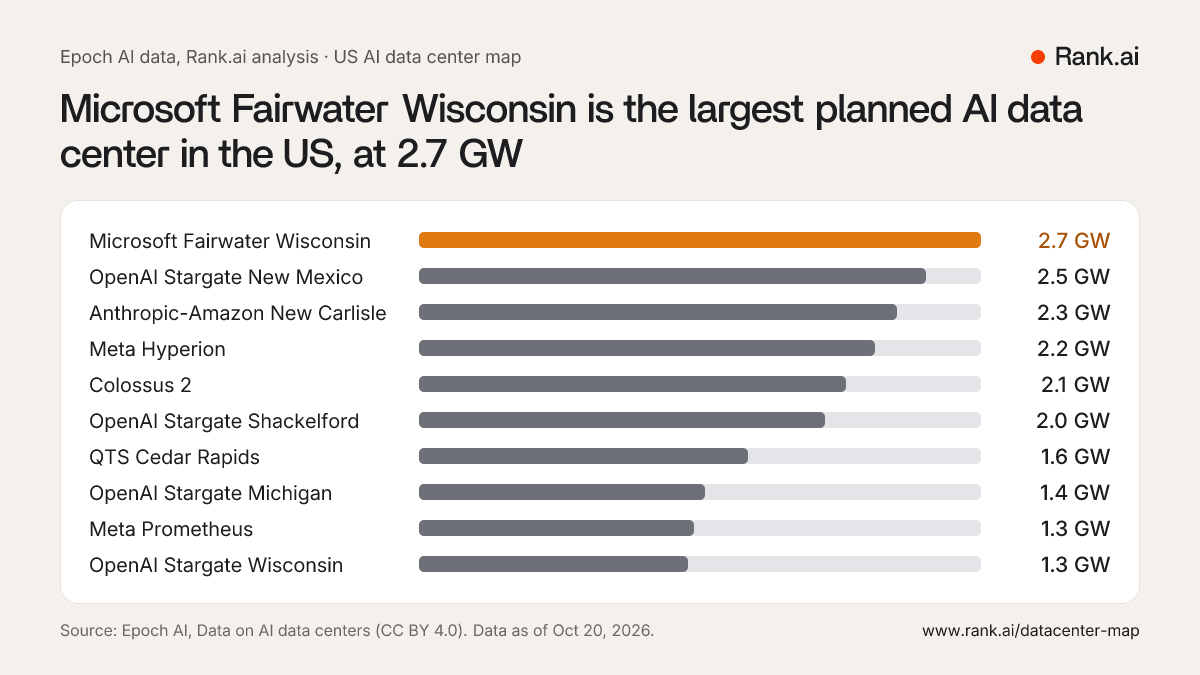

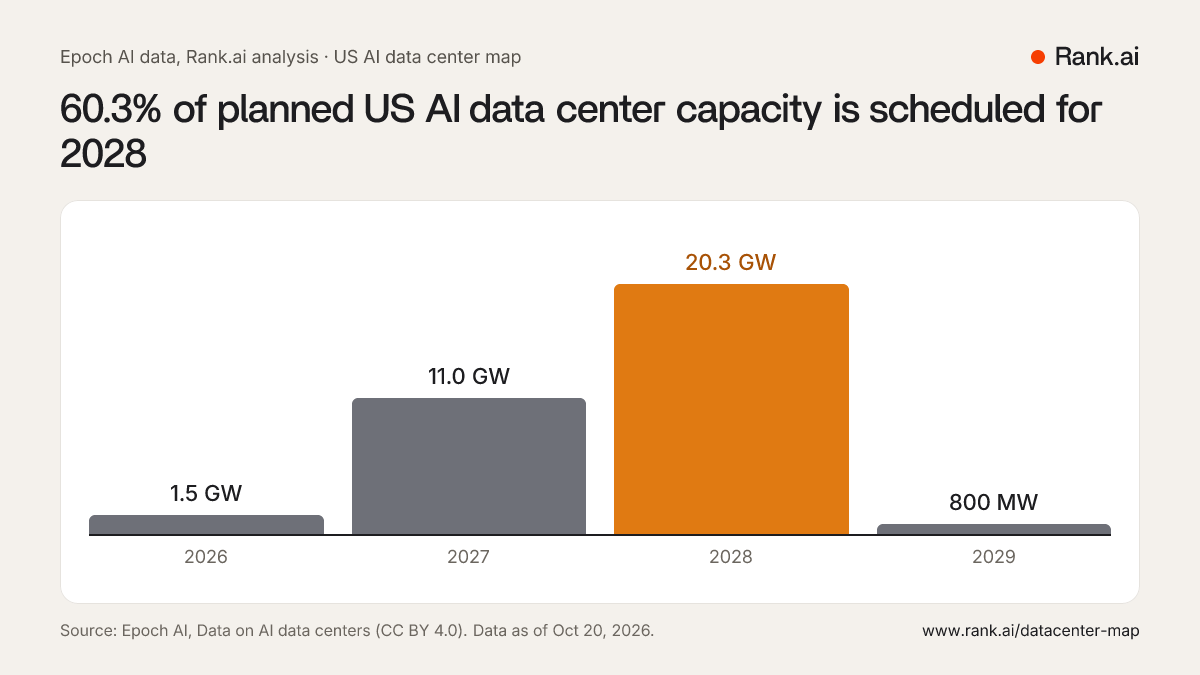

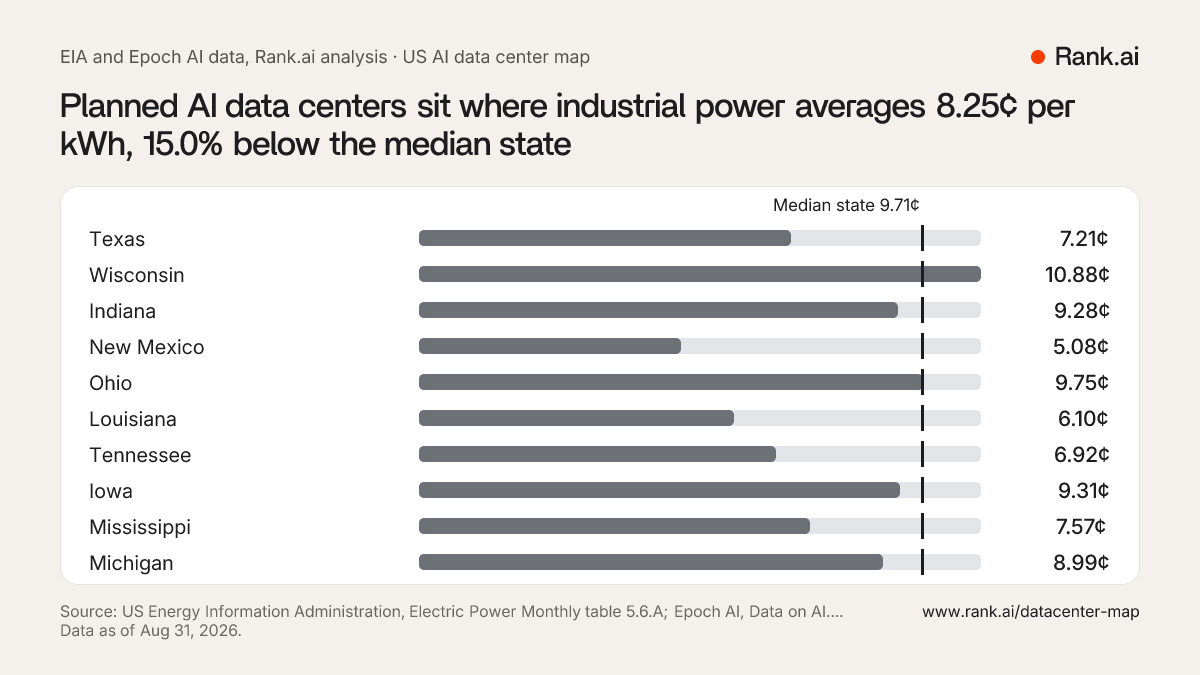

Planned capacity is estimated from reviewed announcements, not metered utility load. Planned does not mean permitted, financed, constructed, or energized. Industrial power prices are statewide EIA retail averages, not negotiated data-center tariffs.
About this map
Each state is shaded by the total facility power of its reviewed planned AI data centers: the projects developers and hyperscalers have announced but not yet energized, summed from Epoch AI's project-level evidence. States without a reviewed planned project stay neutral — missing evidence is treated as unknown, never as zero.
A state's figure is the sum of the latest future-milestone facility-power estimates for distinct reviewed facilities attributed to that state, with site counts and named owners carried from the same records. The industrial power column joins the statewide average retail rate to ultimate industrial customers from the U.S. Energy Information Administration — the public benchmark siting teams start from. Projects leave the map when they are cancelled and graduate off it when they become operational.
Read the map and the power column together: electricity is the largest recurring input cost of an AI data center, and announced capacity clusters where industrial rates are low and land and interconnection are available. Every state links to its own evidence page with project-level detail, grid carbon intensity, and AI workforce data.
